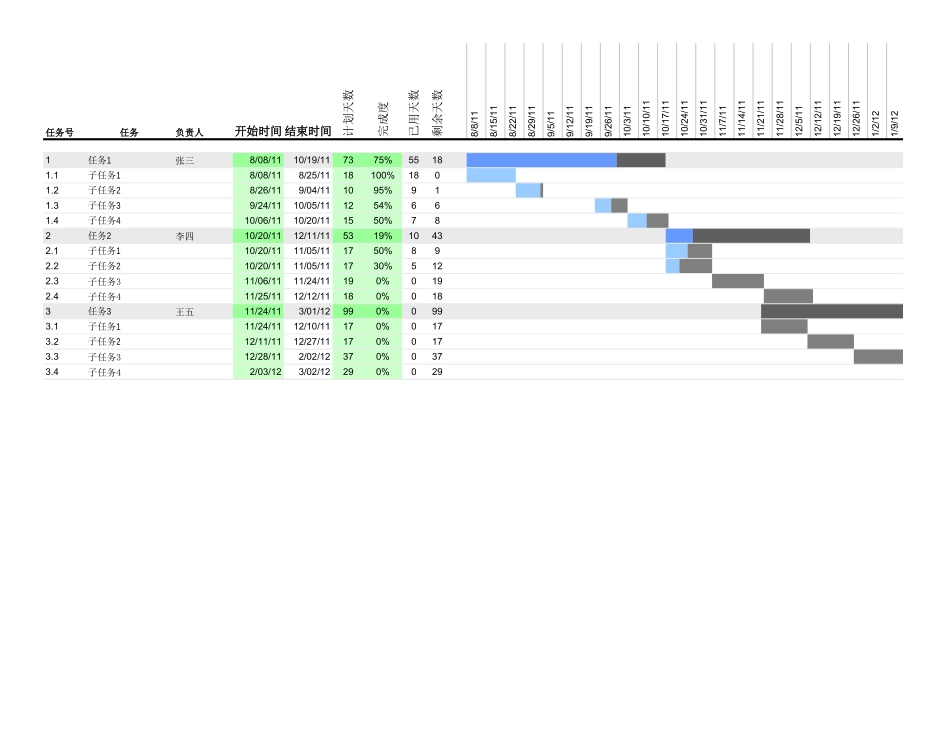

任务号任务负责人开始时间结束时间计划天数完成度已用天数剩余天数8/8/118/15/118/22/118/29/119/5/119/12/119/19/119/26/1110/3/1110/10/1110/17/1110/24/1110/31/1111/7/1111/14/1111/21/1111/28/1112/5/1112/12/1112/19/1112/26/111/2/121/9/121张三8/08/1110/19/117375%55181.18/08/118/25/1118100%1801.28/26/119/04/111095%911.39/24/1110/05/111254%661.410/06/1110/20/111550%782李四10/20/1112/11/115319%10432.110/20/1111/05/111750%892.210/20/1111/05/111730%5122.311/06/1111/24/11190%0192.411/25/1112/12/11180%0183王五11/24/113/01/12990%0993.111/24/1112/10/11170%0173.212/11/1112/27/11170%0173.312/28/112/02/12370%0373.42/03/123/02/12290%029任务1子任务1子任务2子任务3子任务4任务2子任务1子任务2子任务3子任务4任务3子任务1子任务2子任务3子任务4
