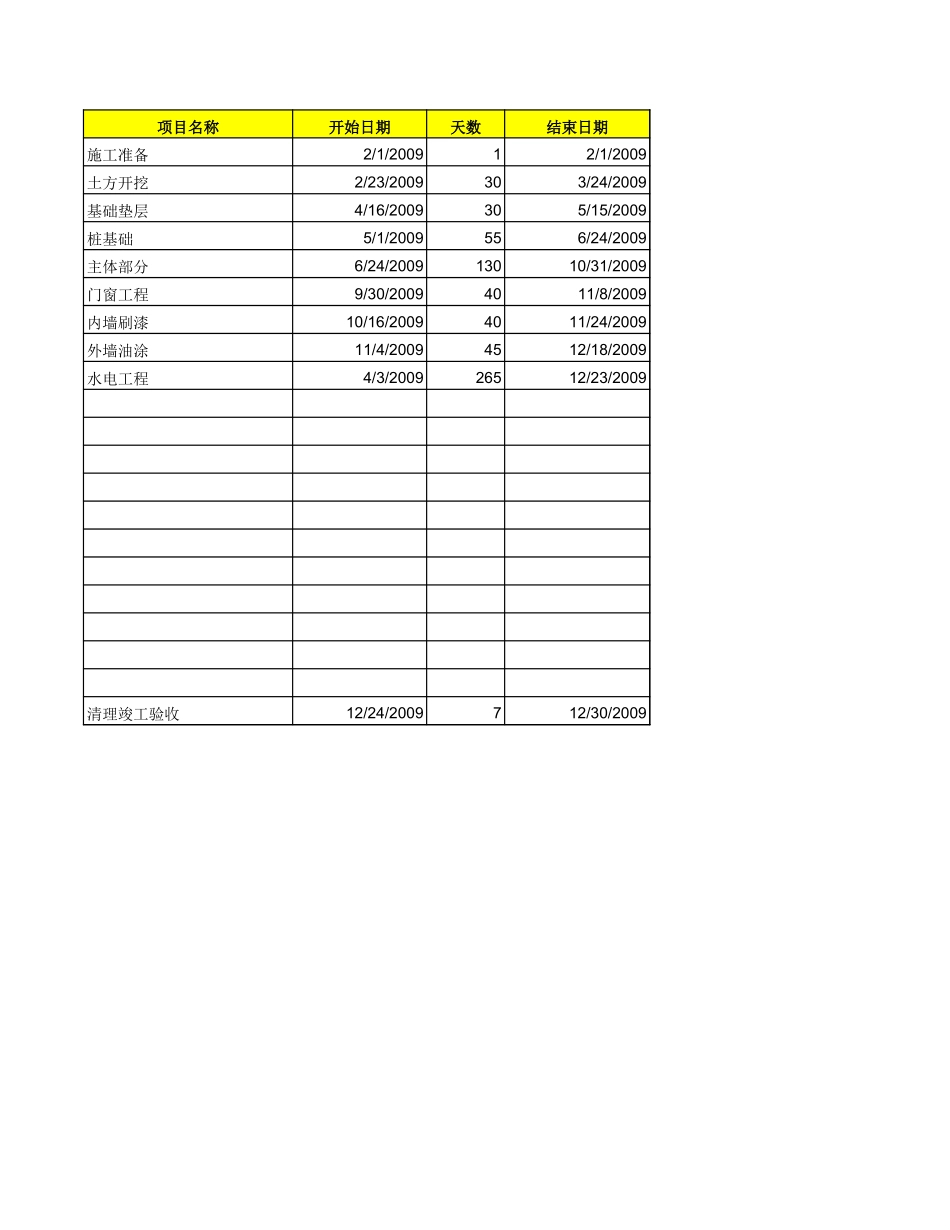

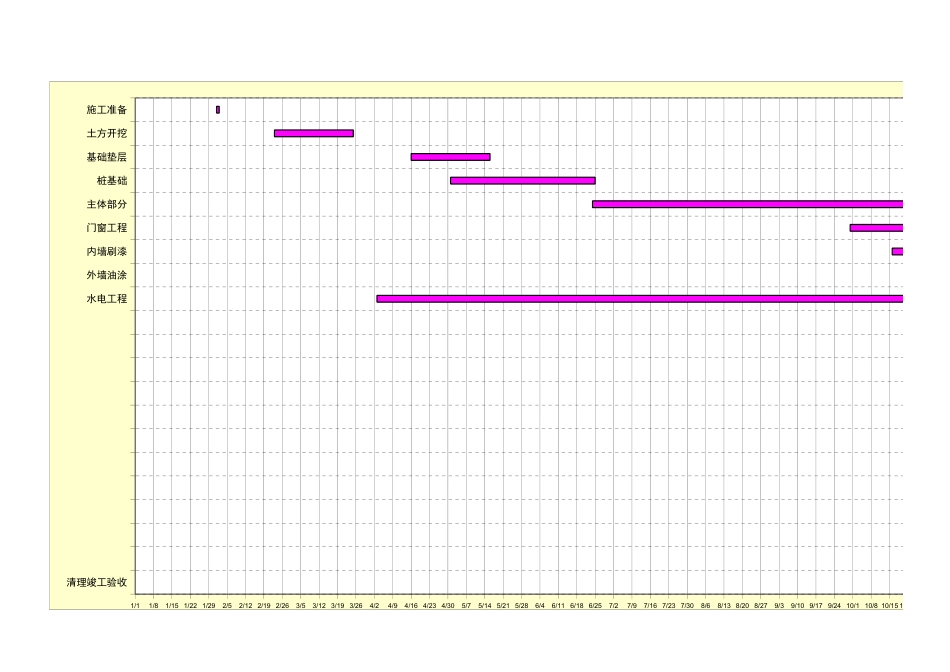

项目名称开始日期天数结束日期施工准备2/1/200912/1/2009土方开挖2/23/2009303/24/2009基础垫层4/16/2009305/15/2009桩基础5/1/2009556/24/2009主体部分6/24/200913010/31/2009门窗工程9/30/20094011/8/2009内墙刷漆10/16/20094011/24/2009外墙油涂11/4/20094512/18/2009水电工程4/3/200926512/23/2009清理竣工验收12/24/2009712/30/2009施工准备土方开挖基础垫层桩基础主体部分门窗工程内墙刷漆外墙油涂水电工程清理竣工验收1/11/81/151/221/292/52/122/192/263/53/123/193/264/24/94/164/234/305/75/145/215/286/46/116/186/257/27/97/167/237/308/68/138/208/279/39/109/179/2410/110/810/1510/2210/2911/56/116/186/257/27/97/167/237/308/68/138/208/279/39/109/179/2410/110/810/1510/2210/2911/511/1211/1911/2612/312/1012/1712/2412/31
