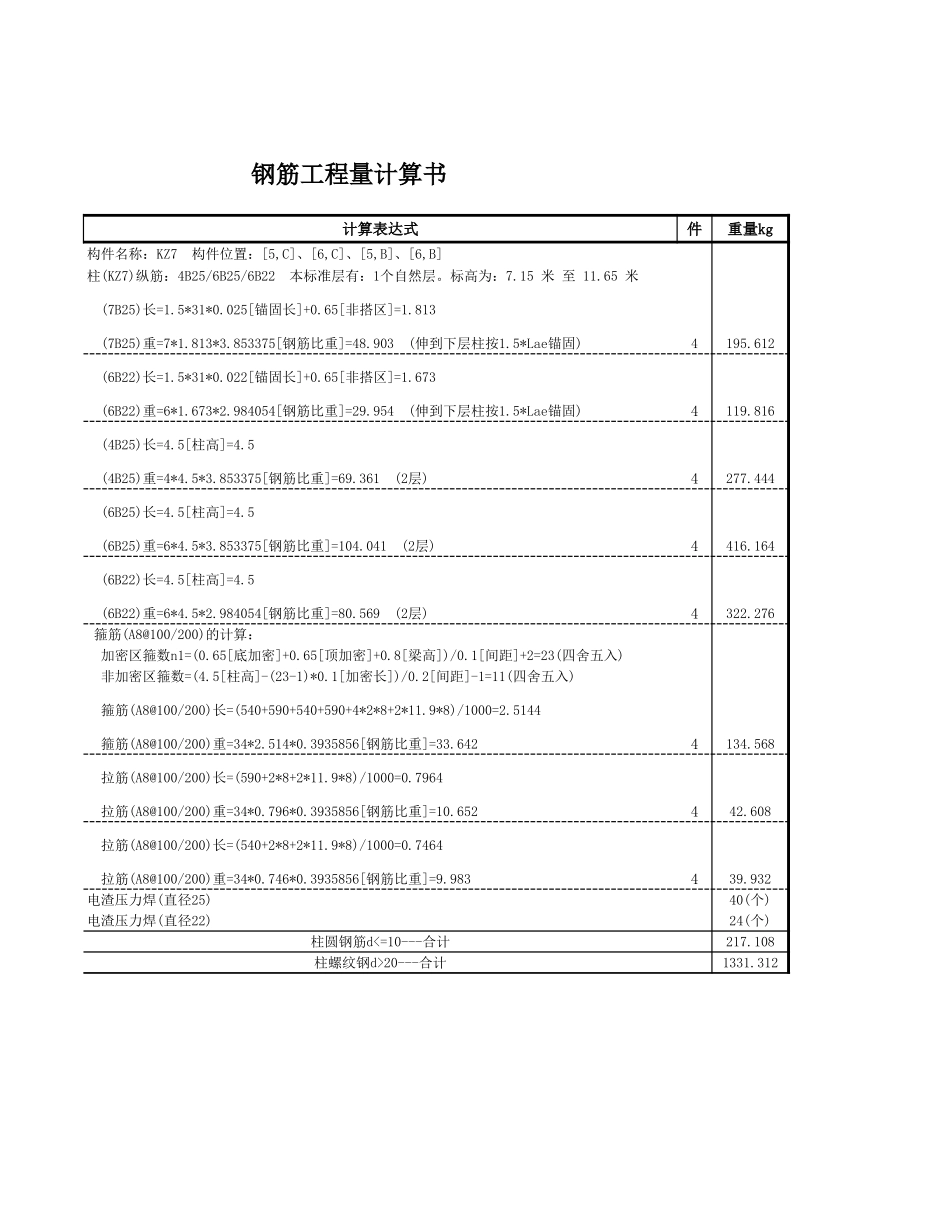

钢筋工程量计算书工程名称:厂房算量钢筋简图7.bmp9.bmp11.bmp13.bmp15.bmp20.bmp22.bmp24.bmp钢筋工程量计算书厂房算量计算表达式件4195.6124119.8164277.4444416.1644322.2764134.568442.608439.932217.1081331.312重量kg构件名称:KZ7构件位置:[5,C]、[6,C]、[5,B]、[6,B]柱(KZ7)纵筋:4B25/6B25/6B22本标准层有:1个自然层。标高为:7.15米至11.65米(7B25)长=1.5*31*0.025[锚固长]+0.65[非搭区]=1.813(7B25)重=7*1.813*3.853375[钢筋比重]=48.903(伸到下层柱按1.5*Lae锚固)(6B22)长=1.5*31*0.022[锚固长]+0.65[非搭区]=1.673(6B22)重=6*1.673*2.984054[钢筋比重]=29.954(伸到下层柱按1.5*Lae锚固)(4B25)长=4.5[柱高]=4.5(4B25)重=4*4.5*3.853375[钢筋比重]=69.361(2层)(6B25)长=4.5[柱高]=4.5(6B25)重=6*4.5*3.853375[钢筋比重]=104.041(2层)(6B22)长=4.5[柱高]=4.5(6B22)重=6*4.5*2.984054[钢筋比重]=80.569(2层)箍筋(A8@100/200)的计算:加密区箍数n1=(0.65[底加密]+0.65[顶加密]+0.8[梁高])/0.1[间距]+2=23(四舍五入)非加密区箍数=(4.5[柱高]-(23-1)*0.1[加密长])/0.2[间距]-1=11(四舍五入)箍筋(A8@100/200)长=(540+590+540+590+4*2*8+2*11.9*8)/1000=2.5144箍筋(A8@100/200)重=34*2.514*0.3935856[钢筋比重]=33.642拉筋(A8@100/200)长=(590+2*8+2*11.9*8)/1000=0.7964拉筋(A8@100/200)重=34*0.796*0.3935856[钢筋比重]=10.652拉筋(A8@100/200)长=(540+2*8+2*11.9*8)/1000=0.7464拉筋(A8@100/200)重=34*0.746*0.3935856[钢筋比重]=9.983电渣压力焊(直径25)40(个)电渣压力焊(直径22)24(个)柱圆钢筋d<=10---合计柱螺纹钢d>20---合计
