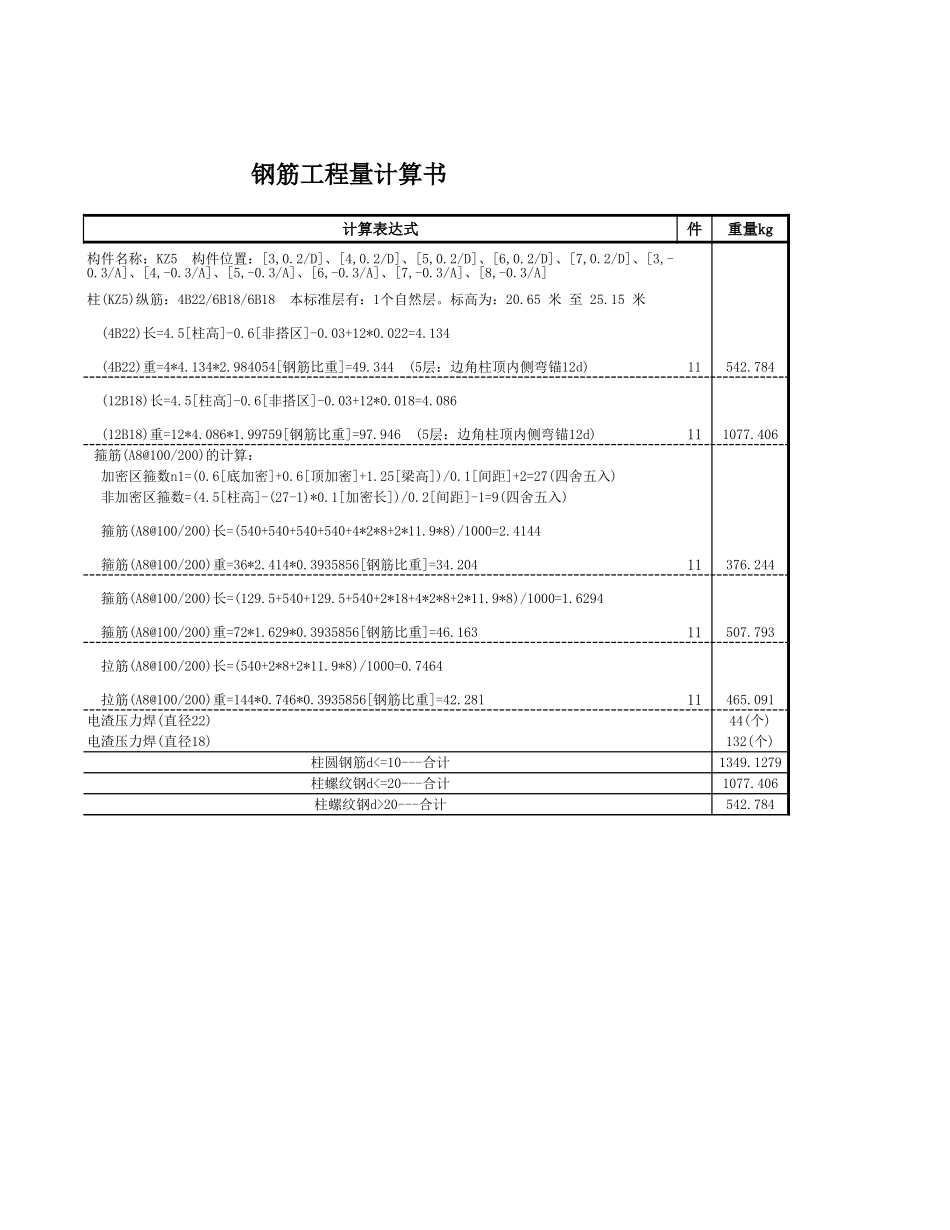

钢筋工程量计算书工程名称:厂房算量钢筋简图7.bmp9.bmp14.bmp16.bmp18.bmp钢筋工程量计算书厂房算量计算表达式件11542.784111077.40611376.24411507.79311465.0911349.12791077.406542.784重量kg构件名称:KZ5构件位置:[3,0.2/D]、[4,0.2/D]、[5,0.2/D]、[6,0.2/D]、[7,0.2/D]、[3,-0.3/A]、[4,-0.3/A]、[5,-0.3/A]、[6,-0.3/A]、[7,-0.3/A]、[8,-0.3/A]柱(KZ5)纵筋:4B22/6B18/6B18本标准层有:1个自然层。标高为:20.65米至25.15米(4B22)长=4.5[柱高]-0.6[非搭区]-0.03+12*0.022=4.134(4B22)重=4*4.134*2.984054[钢筋比重]=49.344(5层:边角柱顶内侧弯锚12d)(12B18)长=4.5[柱高]-0.6[非搭区]-0.03+12*0.018=4.086(12B18)重=12*4.086*1.99759[钢筋比重]=97.946(5层:边角柱顶内侧弯锚12d)箍筋(A8@100/200)的计算:加密区箍数n1=(0.6[底加密]+0.6[顶加密]+1.25[梁高])/0.1[间距]+2=27(四舍五入)非加密区箍数=(4.5[柱高]-(27-1)*0.1[加密长])/0.2[间距]-1=9(四舍五入)箍筋(A8@100/200)长=(540+540+540+540+4*2*8+2*11.9*8)/1000=2.4144箍筋(A8@100/200)重=36*2.414*0.3935856[钢筋比重]=34.204箍筋(A8@100/200)长=(129.5+540+129.5+540+2*18+4*2*8+2*11.9*8)/1000=1.6294箍筋(A8@100/200)重=72*1.629*0.3935856[钢筋比重]=46.163拉筋(A8@100/200)长=(540+2*8+2*11.9*8)/1000=0.7464拉筋(A8@100/200)重=144*0.746*0.3935856[钢筋比重]=42.281电渣压力焊(直径22)44(个)电渣压力焊(直径18)132(个)柱圆钢筋d<=10---合计柱螺纹钢d<=20---合计柱螺纹钢d>20---合计
