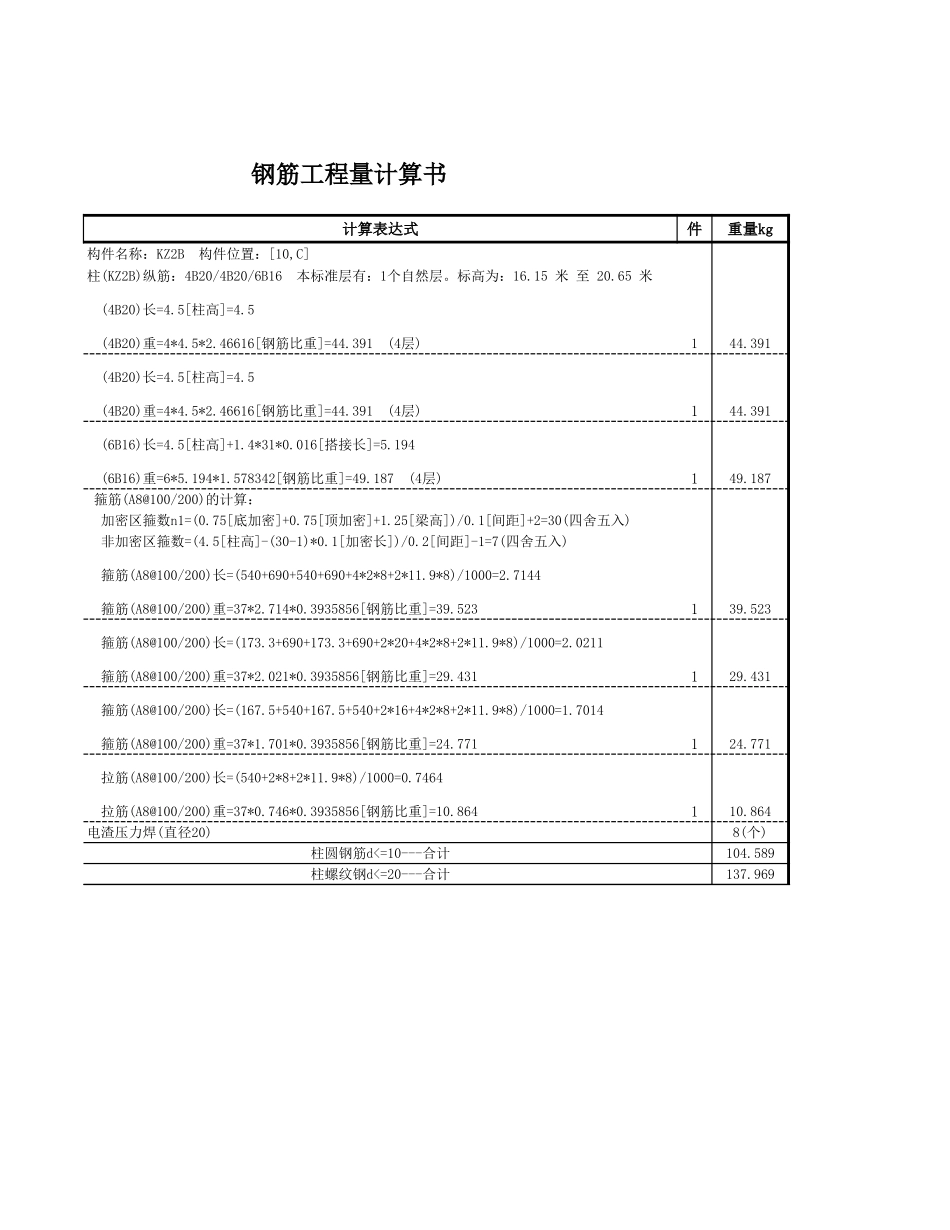

钢筋工程量计算书工程名称:厂房算量钢筋简图7.bmp9.bmp11.bmp16.bmp18.bmp20.bmp22.bmp钢筋工程量计算书厂房算量计算表达式件144.391144.391149.187139.523129.431124.771110.864104.589137.969重量kg构件名称:KZ2B构件位置:[10,C]柱(KZ2B)纵筋:4B20/4B20/6B16本标准层有:1个自然层。标高为:16.15米至20.65米(4B20)长=4.5[柱高]=4.5(4B20)重=4*4.5*2.46616[钢筋比重]=44.391(4层)(4B20)长=4.5[柱高]=4.5(4B20)重=4*4.5*2.46616[钢筋比重]=44.391(4层)(6B16)长=4.5[柱高]+1.4*31*0.016[搭接长]=5.194(6B16)重=6*5.194*1.578342[钢筋比重]=49.187(4层)箍筋(A8@100/200)的计算:加密区箍数n1=(0.75[底加密]+0.75[顶加密]+1.25[梁高])/0.1[间距]+2=30(四舍五入)非加密区箍数=(4.5[柱高]-(30-1)*0.1[加密长])/0.2[间距]-1=7(四舍五入)箍筋(A8@100/200)长=(540+690+540+690+4*2*8+2*11.9*8)/1000=2.7144箍筋(A8@100/200)重=37*2.714*0.3935856[钢筋比重]=39.523箍筋(A8@100/200)长=(173.3+690+173.3+690+2*20+4*2*8+2*11.9*8)/1000=2.0211箍筋(A8@100/200)重=37*2.021*0.3935856[钢筋比重]=29.431箍筋(A8@100/200)长=(167.5+540+167.5+540+2*16+4*2*8+2*11.9*8)/1000=1.7014箍筋(A8@100/200)重=37*1.701*0.3935856[钢筋比重]=24.771拉筋(A8@100/200)长=(540+2*8+2*11.9*8)/1000=0.7464拉筋(A8@100/200)重=37*0.746*0.3935856[钢筋比重]=10.864电渣压力焊(直径20)8(个)柱圆钢筋d<=10---合计柱螺纹钢d<=20---合计
